Crushing & Aggregates

Mobile vs. Stationary Crushing Plants: Which Is Right for Your Operation?

Mobile or stationary crushing plant? A comparison of capital cost, capacity, flexibility and operating cost per tonne.

Crushing and screening plant on site

Key takeaways

  • Mobile plants: about 50 to 500 tph, higher price per capacity, minimal civil works, relocation in hours.
  • Stationary plants: about 100 to over 1,000 tph, lower cost per tonne for permanent high-volume sites.
  • Stationary plants typically run at 10 to 15% lower cost per tonne thanks to grid power, less wear and higher utilisation.

Mobile plants offer flexibility and fast deployment. Stationary plants offer higher capacity and lower long-term operating costs. The right answer depends on site conditions, production targets, and project timeline.

Capital Cost

Mobile: Higher upfront purchase price for equivalent capacity, but eliminates civil engineering costs: foundations, power distribution, access roads. Civil work can represent 3–6 months of time and significant capital on a greenfield site.

Stationary: Lower equipment purchase price for equivalent capacity; civil infrastructure costs must be added. For permanent high-capacity operations, total installed cost of a stationary plant is typically lower.

Production Capacity

Mobile: Practical capacity range: 50–500 tph. Compact, self-contained design limits maximum throughput.

Stationary: Scales from 100 tph to over 1,000 tph. Only practical choice for large-scale, high-volume operations.

Flexibility and Deployment

Mobile: Can move to a new working face as the quarry progresses, follow road construction across hundreds of kilometres, or relocate between sites. Setup after relocation: hours, not weeks.

Stationary: Once installed, does not move. Relocating a stationary plant is a major undertaking: dismantling, transport, and reinstallation can take months.

Operating Cost per Tonne

Stationary plants typically operate at 10–15% lower cost per tonne than equivalent mobile plants due to: (1) grid power vs. diesel, (2) lower maintenance frequency from constant movement, (3) higher annual utilisation.

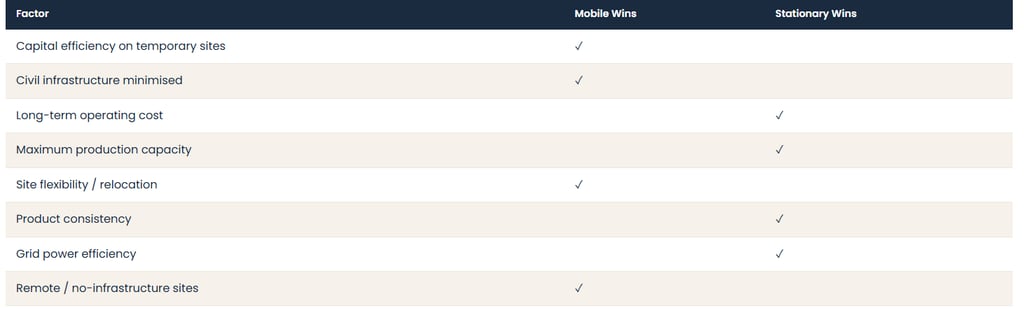

Side-by-side comparison

FactorMobileStationary
Practical capacity50 to 500 tph100 to over 1,000 tph
Equipment price for equal capacityHigherLower
Civil worksMinimalFoundations, power distribution, access roads
RelocationHoursMonths
Operating cost per tonneHigherTypically 10 to 15% lower

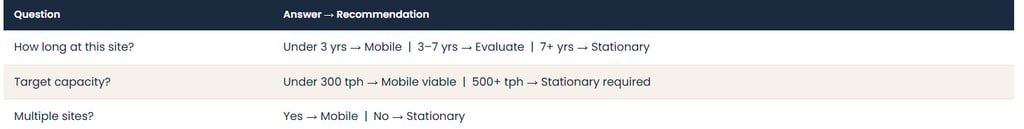

How to decide

  • Choose mobile when the work face moves, the project is temporary or spread over several sites, or you need to start production quickly.
  • Choose stationary when the site is permanent, volumes are high and grid power is available.

VDA sources both mobile and stationary crushing and screening plants from Turkish manufacturers. Share your material, target capacity and site conditions, and we will come back with suitable configurations to compare.

Frequently asked questions

Which crushing plant has the higher capacity?

Stationary plants scale from about 100 tph to over 1,000 tph; mobile plants typically cover about 50 to 500 tph.

When is a mobile crushing plant the better choice?

When the work face moves, the project is temporary or spread over several sites, or production must start quickly without civil works.
